Hero image

London Bridge Preventative Maintenance

Description of Works

FM Conway’s Structures division has successfully delivered London Bridge’s first major maintenance programme in half a century, helping to rejuvenate the famous river crossing for years to come.

Spanning 283m long with a three span prestressed concrete box girder, London Bridge has been standing since 1973, and now after almost 50 years of operation has undergone a major preventative maintenance project to ensure that one of the world’s most famous bridges is set to withstand the test of time once more.

Services used on this project Structures
Delivering Innovation

Working for the City of London Corporation, FM Conway was contracted with replacing the deteriorating waterproofing, laying a new carriageway surface, as well as carrying out a repair of the damaged concrete deck and replacing the structure’s support bearings.

In order to achieve this, FM Conway was required to remove the existing surfacing over the carriageway and footways, using a full depth planer to mill out 2,500t of materials, which was then taken to its Dartford plant for recycling. Once exposed, the concrete deck underwent repairs, before a new waterproofing layer covering 9,580m2 was installed on the bridge.

Following this a new central reservation was cast, paving and kerbs on the west footpath reinstated and the west carriageway was surfaced. To ensure that the bridge could remain operational throughout the works, the team focused on one carriageway at a time, enabling traffic to be switched for the same work to be done on the east carriageway.

Whilst this was happening, the team simultaneously replaced the structures support bearings, initially focusing on 12 in the north abutment. By using hydraulic jacks between each bearing, the structure was jacked up 2mm so that the team could enter the confined space, remove the old bearings and install new ones.

However, the south abutment required a different method. Using a suspended working scaffold platform under the bridge, the team used hydro-demolition to remove the other 12 old bearings before removing the contaminated water from site.

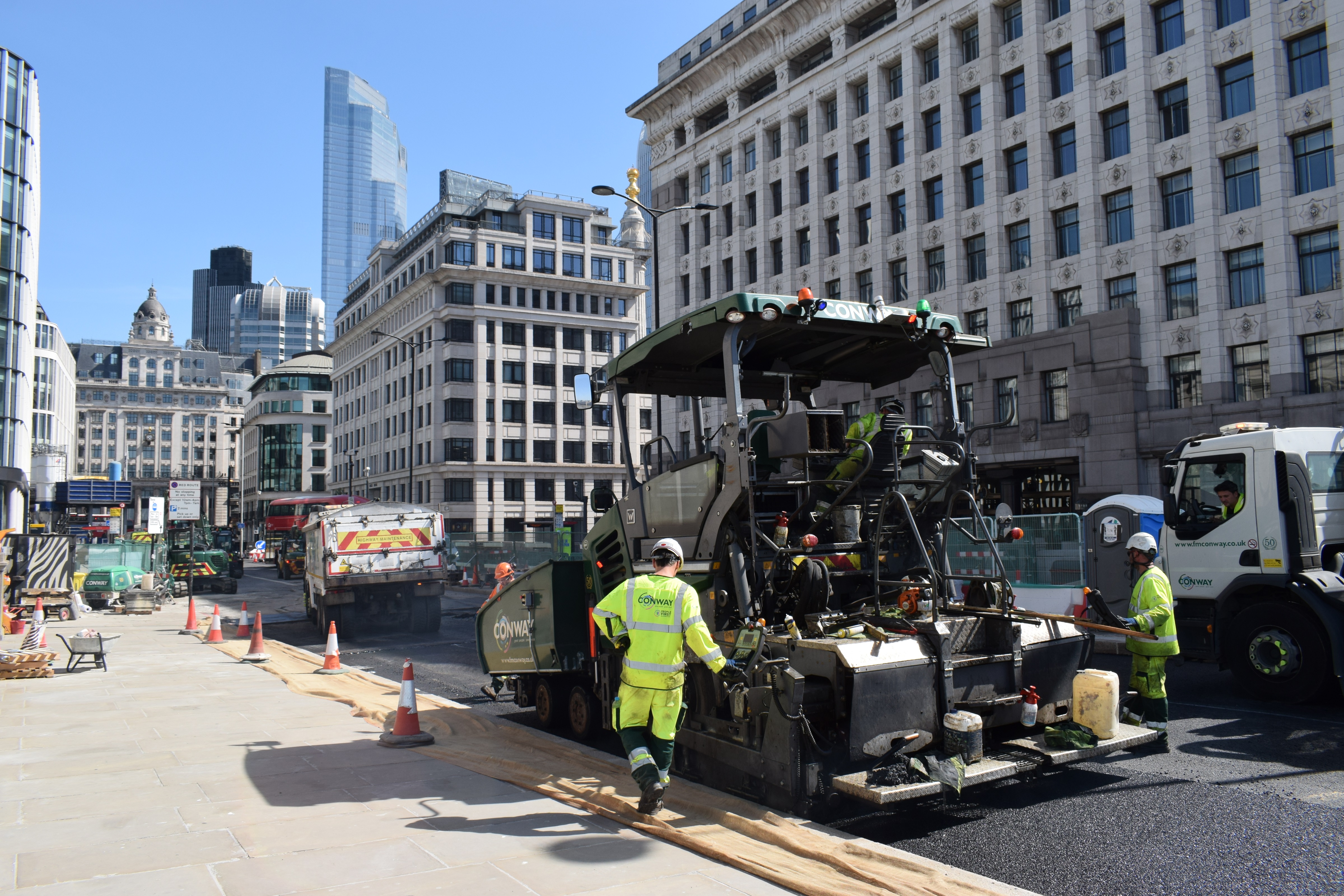

/files/library/images/Case studies/Structures/London_Bridge.JPG

When the rest of London shut down, FM Conway created new procedures to allow the works at London Bridge to continue.

City of London Engineer - Trina de Silva
Challenges and Solutions

Delivering a project on one of the Thames’ busiest river crossings was a logistical challenge in itself, due to the structure usually featuring a footfall of 60,000 people per rush hour, including having 12 different bus routes run across it.

This required the team to liaise with a number of stakeholders, including Transport for London (TfL), to close the bridge to general traffic, but to keep it open for buses, taxis, motorcycles, cyclists and pedestrians.

“Because of where it is situated, a huge number of stakeholders are involved, including the Port of London Authority, the Marine Management Organisation, Environment Agency, Metropolitan Police, City of London Police, Counter Terrorism Police, TfL and London buses,” says Project Manager, John Briggs.



Outcomes

Despite its challenges, the COVID-19 pandemic also presented an opportunity, and thanks to FM Conway’s ability to adapt to trying circumstances, the work could be finished swiftly.

“When the rest of London shut down, FM Conway created new procedures to allow the works at London Bridge to continue,” said City of London Engineer, Trina de Silva.

“This resulted in an early completion of the works, with minimal public disruption. The work we have completed on London Bridge will ensure it remains operations for years to come.”
